Civil infrastructure project · Blackbutt, NSW

Pavement Reconstruction at Blackbutt

The Blackbutt pavement reconstruction combined deep excavation, lime stabilisation, rebuilt pavement layers, stormwater adjustments, kerbs, landscaping and line marking.

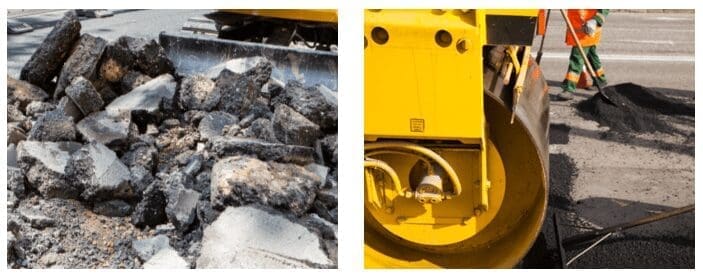

Pavement removal and asphalt resurfacing during SCE's Blackbutt NSW reconstruction project
Pavement removal and asphalt treatment during the Blackbutt works.

Project overview

Rebuilding a deteriorated pavement corridor

SCE reconstructed the pavement corridor and coordinated drainage, kerbs and finishing works within a two-stage construction programme. Explore Civil Services for the wider construction capability behind this work.

Location

Blackbutt, NSW

A regional pavement-reconstruction setting with staging, access and existing-infrastructure constraints.

Project type

Civil pavement reconstruction

Subgrade and pavement-layer work supported by drainage, kerb, landscaping and line-marking activities.

Project delivery

Two-stage works sequence

SCE changed a five-stage plan to two stages, reconstructing one side of the road at a time while maintaining residents’ access.

Scope of work

Work across the pavement build-up and streetscape

  • Project assessment, planning and surface preparation.
  • Excavation of existing pavement to 1.5 metres below subbase level.
  • Lime stabilisation of the existing subgrade and backfill material.
  • Preparation and grading of subbase and base-course layers.
  • Installation of flexible pavement.
  • Adjustment of the existing stormwater system and reconstruction of kerbs.
  • Street landscaping, line marking and quality-assurance activities.

Delivery approach

Coordinating staging, pavement layers and existing services

Staging coordination, lime stabilisation and the integration of stormwater, kerb, landscaping and line-marking work were key delivery considerations. These activities required the pavement sequence to be coordinated around existing conditions and the two-stage programme.

How did SCE maintain residents’ access in two stages?

The original proposal divided the road reconstruction into five stages so residents could continue accessing their properties. SCE reviewed the staging and changed it to reconstruct one side of the road, then the other. This maintained access for all residents throughout the works while giving the construction team a more continuous area to rebuild.

The change addressed the reason for staging the project, rather than treating five separate work areas as fixed. For another road project, SCE’s roadworks access and staging review starts with the routes people need to use, then assesses how the construction boundaries and sequence can support those requirements.

Compaction testing, survey checks and quality records supported the delivery and handover process. Review SCE’s qualifications, certifications and insurance alongside this project experience.

Project outcome

Reconstructed pavement and supporting works

The completed scope combined pavement reconstruction with stormwater, kerb, landscaping and line-marking works.

Related services and projects

Continue from this project

Explore SCE civil projects, road construction services and our project delivery system.

Road maintenance and pavement rehabilitation services — discuss a defined repair, resurfacing or reconstruction package.

Frequently asked questions

Blackbutt pavement reconstruction

Our civil access and delivery questions cover plant selection, site access and organising civil work.

What work did SCE complete for the Blackbutt pavement project?

The scope included assessment and preparation, deep pavement excavation, lime stabilisation, subbase and base-course work, flexible pavement, stormwater adjustments, kerb reconstruction, landscaping, line marking and quality-assurance activities.

How was the Blackbutt project staged?

The original proposal used five stages to maintain residents’ access. SCE changed the sequence to reconstruct one side of the road, then the other, in two stages. This maintained access for all residents throughout the works and gave the construction team a more continuous area for road reconstruction.

What pavement layers and treatments were included?

The work included lime stabilisation of existing subgrade and backfill, preparation and grading of subbase and base-course layers, and installation of flexible pavement.

Were drainage, kerbs and line marking included?

Yes. The scope included adjustment of the stormwater system, kerb reconstruction, street landscaping and line marking.

Where can I see related civil infrastructure projects?

Visit SCE's Civil Infrastructure Projects collection for related project work.

Planning pavement reconstruction or road civil works?

Share the site location, available drawings, pavement condition, access constraints and intended programme with SCE so we can plan the engineering, construction and handover requirements. Our project planning tools can help organise the information, and our service locations explain regional delivery.
