Completed SCE project

Lane Cove School Structural Remedial Project

SCE Corp completed structural remediation and sewer-line replacement at a private school in Lane Cove during the December 2025 school holidays. The work included temporary structural support, excavation and investigation, structural steel, a new permanent footing, replacement sewer pipework, backfilling and reinstatement.

Project overview

Movement was observed in an existing masonry pier. SCE established an exclusion zone, coordinated the required structural-engineer input and delivered temporary support, controlled investigation, permanent structural repairs, replacement of the broken sewer line and reinstatement.

Location Lane Cove, NSW
Client setting Preschool and primary school
SCE role Remedial construction and coordination
Project status Completed December 2025

Structural repair delivery sequence

The completed works followed a controlled six-stage sequence.

Pier movement assessed

The observed movement in the existing masonry pier was assessed to define the immediate risk and investigation requirements.

Exclusion zone established

The affected area was isolated to control access while the structural condition and adjoining services were investigated.

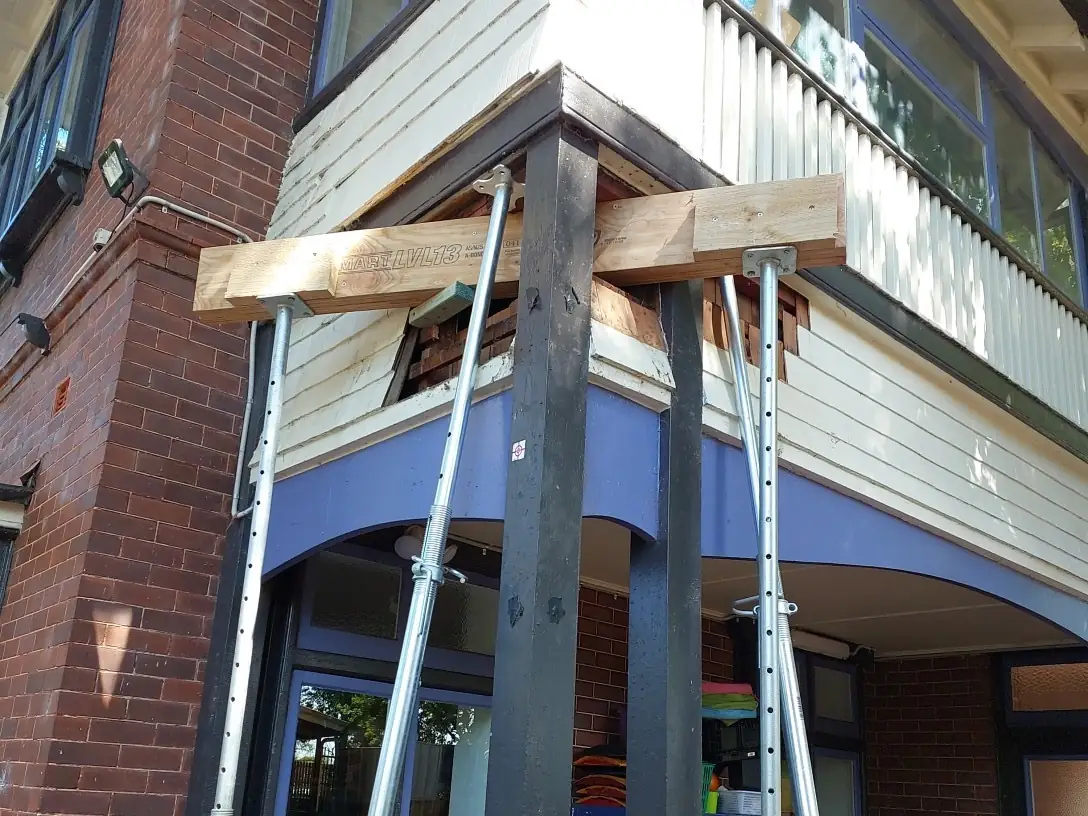

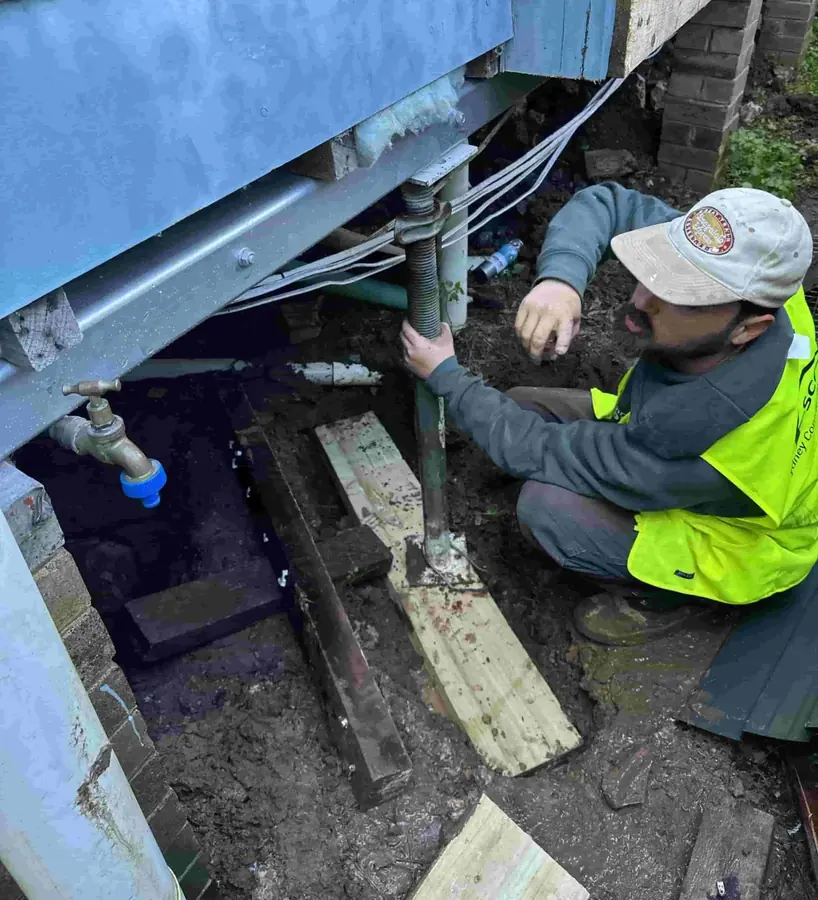

Temporary support installed

Temporary structural support maintained stability and load transfer during excavation and removal of affected elements.

Cause of subsidence identified

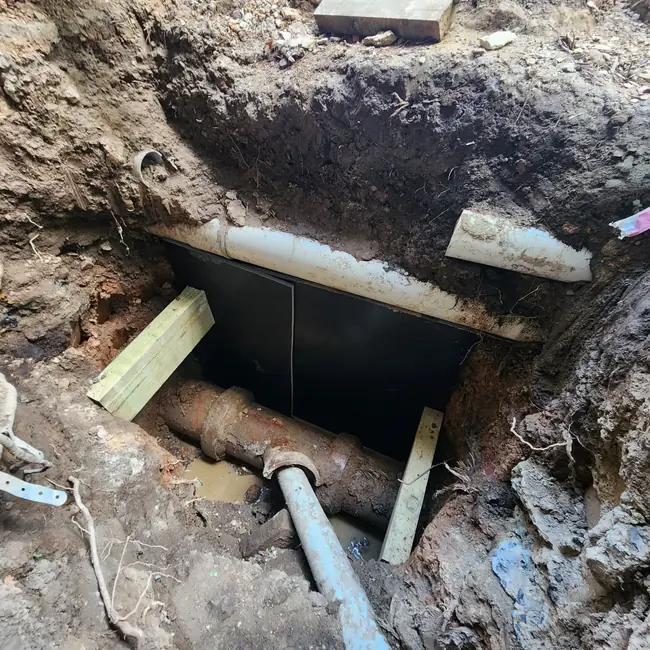

Controlled excavation exposed the affected footing zone and identified the broken sewer line associated with the subsidence.

Permanent structural repair completed

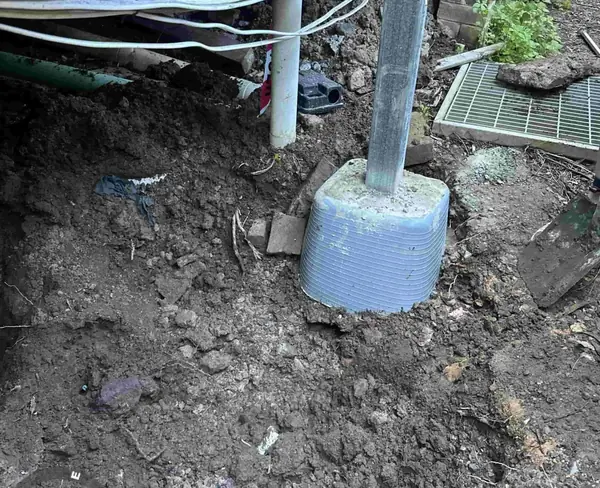

The approved repair included structural steel and a new permanent footing, delivered to the structural engineer’s design requirements.

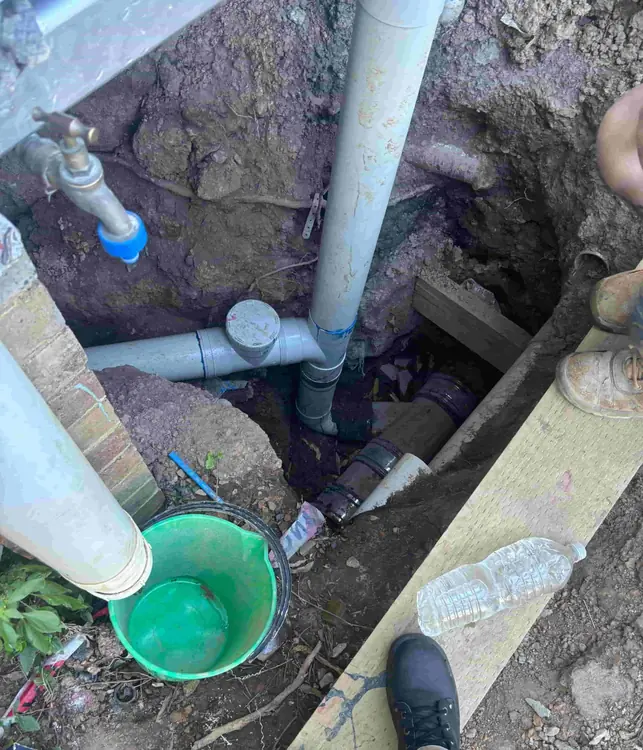

Broken sewer line replaced

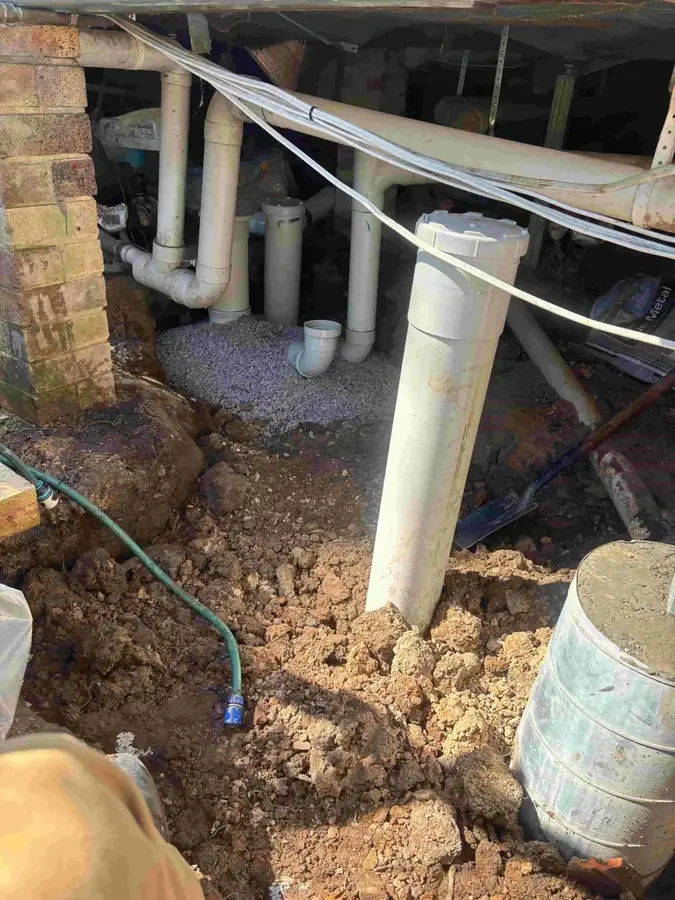

Replacement sewer pipework was connected before controlled backfilling and final reinstatement of the work area.

School-site, access and engineering controls

The programme and construction sequence were planned around the school setting, restricted access and structural risk.

School-holiday programme

The works were completed during the December 2025 school holidays to separate the construction activities from normal school operations.

Restricted-access delivery

Excavation and material handling were carefully staged for the constrained work area, with the exclusion zone maintained around the affected structure.

Engineering and construction coordination

SCE integrated the excavation, structural steel, footing, sewer replacement and reinstatement, coordinating the construction sequence with the structural engineer’s design and certification requirements.

Lane Cove school project video

The project video records selected stages of the completed structural remedial and sewer-line works.

Structural remedial works completed at a private school in Lane Cove, NSW.

Watch the Lane Cove structural remedial video

Project photographs

These genuine SCE project photographs document the affected pier, temporary support, service exposure, permanent repairs and reinstatement.

Completed project outcome

SCE completed the structural repair, replacement sewer-line connection, backfilling and reinstatement during the December 2025 school holidays. The affected pier and footing zone were stabilised through the permanent structural works, and the broken sewer line was replaced.

From investigating the subsidence to delivering the permanent structural repair and replacement sewer connection, SCE brought the building and civil work together within the school-holiday programme.

Frequently asked questions

What work did SCE complete at a private school in Lane Cove?

SCE assessed the pier movement, established an exclusion zone, installed temporary support and investigated the footing and services. The permanent work included structural steel, a new footing, replacement of the broken sewer line, backfilling and reinstatement, coordinated with the structural engineer’s requirements.

Why was an exclusion zone established?

The exclusion zone controlled access around the affected masonry pier while its movement, the footing zone and adjoining services were investigated and repaired.

What caused the subsidence near the affected pier?

Controlled excavation identified a broken sewer line in the affected footing zone associated with the subsidence. The damaged line was replaced before backfilling and reinstatement.

How were the structural repair and sewer-line works coordinated?

Temporary support maintained stability while the affected area was excavated. SCE coordinated and delivered the construction works, including structural steel, the permanent footing and sewer-line replacement. Structural design and certification remained with the appropriately qualified structural engineer.

When were the Lane Cove school works completed?

All works described on this page were completed during the December 2025 school holidays.

Discuss a structural remedial project

Contact SCE Corp to discuss the observed condition, available reports, access constraints, safety requirements, approvals, programme and construction scope.
