Apartment common-area upgrade in Artarmon
Work in progress | 16 November 2026
Coordinating repairs and refurbishment
Sydney Contracting Engineers is delivering an ongoing common-area upgrade at an Artarmon strata property, bringing repair work, interior refurbishment and access-system improvements into one coordinated project.
What is a strata plan in NSW?
The strata plan identifies each lot and the common property. For work around shared entrances and walkways, check the plan and relevant by-laws before assigning responsibility or changing access. The NSW strata ownership guide explains how those boundaries are recorded. Artarmon’s project concerns common areas serving 48 apartments.
SCE is upgrading the shared spaces of an occupied 48-apartment building in Artarmon. The works bring entrance replacement, lobby finishes, external finishes and new letterboxes together while residents continue to use the property. The programme matters to the owners corporation because work at the front entrance affects everyone in the building.
A common-area refurbishment involves more than choosing new tiles and paint. Work to entrances, shared rooms, walkways and building systems needs to be sequenced around the way people use the property. For the owners corporation, understanding the scope and the arrangements for each stage is part of making the work manageable.
At this Artarmon property, SCE is coordinating a package that combines repairs with broader improvements to shared spaces. The work is ongoing as at 16 November 2026.
Repairs within a broader upgrade

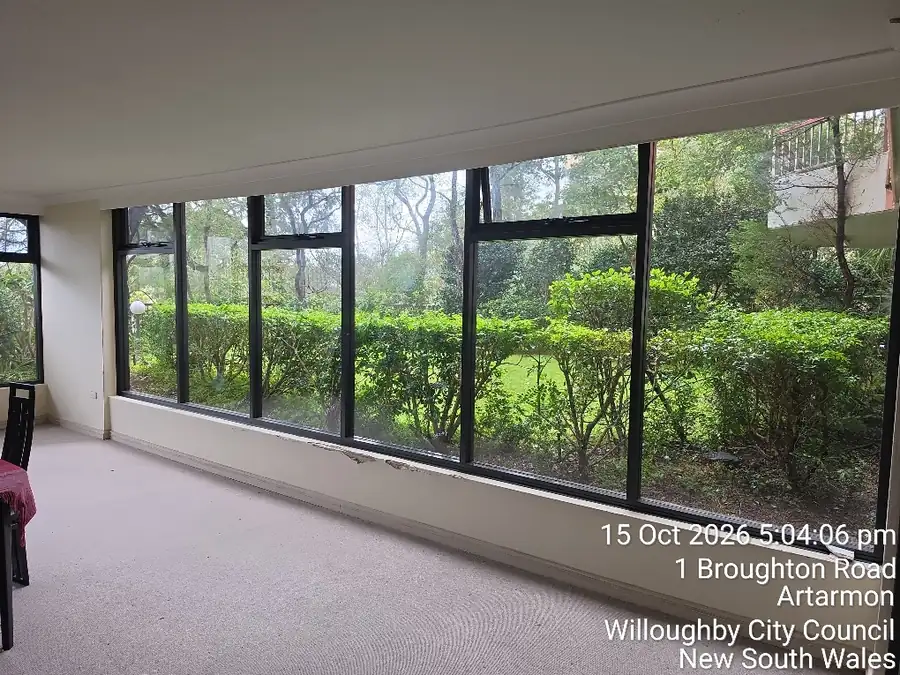

The agreed scope includes repairing and repainting a water-damaged wall in the meeting room, replacing selected common-area doors and windows, preparing surfaces, renewing floor and wall finishes, and upgrading lighting.
Who is responsible for strata repairs in NSW?
The owners corporation generally arranges common-property repairs and owners maintain the parts of their individual lots. Check the plan and by-laws for the specific element. At Artarmon the common-area scope includes a water-damaged meeting-room wall alongside broader refurbishment. The NSW strata repairs guide explains responsibilities.
Outside, the package includes reconstruction of the tiled walkway with reinforced concrete and new finishes. A site photograph from 5 November records formwork and reinforcing mesh during preparation. The dated photograph records that stage of the walkway reconstruction.
Does remediation mean repair?
Repair corrects damage. Remediation also addresses its cause or consequences. At Artarmon it helps to distinguish the repair items within the wider upgrade from the new finishes and entrance improvements.
The owners corporation has also approved additional brickwork infill and an epoxy finish. This work forms part of the current delivery scope.
For related work, explore SCE’s building remedial services and common-area refurbishment service.

Coordinating work around shared spaces
The interior photographs from 12 November show floor protection and unfinished wall surfaces while refurbishment continues. The protective sheeting covers the shared floors while work to the surrounding interior continues.
The package also includes intercom and access-system upgrades. These require coordination of access to individual units and agreement on the installation arrangements. SCE is coordinating those arrangements with the owners corporation before the affected installation stages.
SCE is bringing together the relevant trades, material selections and work stages under the building contract. The value for the owners corporation lies in managing the interfaces between repairs, finishes, external works and building systems as one project.


A progress record, with the outcome still to come
This update records the agreed scope and the work shown in the dated photographs. Construction is continuing, with further stages still to be delivered.
For owners corporations planning similar work, a useful starting point is a clear description of the affected areas, current photographs, available reports, access constraints and the intended timing. Submit those details through SCE’s website enquiry form so the team can review the requirements before arranging a discussion.
Earlier project record: 16 October 2026
The following photographs and construction-stage notes preserve the October progress record. They describe the position at that date; the November update above records the subsequent scope and photographs.
At the 16 October 2026 progress update, Sydney Contracting Engineers was upgrading the shared spaces of an occupied apartment building in Artarmon, on Sydney’s Lower North Shore. The project covers 48 apartments and brings together entrance replacement, lobby and external finishes, new letterboxes and building-access coordination.
The windows, doors and electrically operated doors were complete at that stage, along with the initial demolition. SCE was coordinating the remaining finishes, equipment and trade packages while managing resident communication and the changing work areas.
This project shows how our common-area refurbishment service brings construction, procurement and occupied-building planning together.

- Location
- Artarmon, NSW
Lower North Shore - Building context
- 48 apartments
Occupied throughout the works - Stage at 16 October 2026
- Entrance replacements complete
Wider refurbishment underway
New windows, doors and entrances
Replacement glazing and doors are an early completed stage of the refurbishment. The surrounding finishes continue through the remaining programme.
Are windows strata responsibility?
External windows are commonly treated as common property, but the scheme’s registered plan and any applicable by-laws should be checked. At Artarmon, replacement windows and entrance doors formed an early completed stage of the owners corporation’s upgrade. Record which associated finishes or fittings are included.

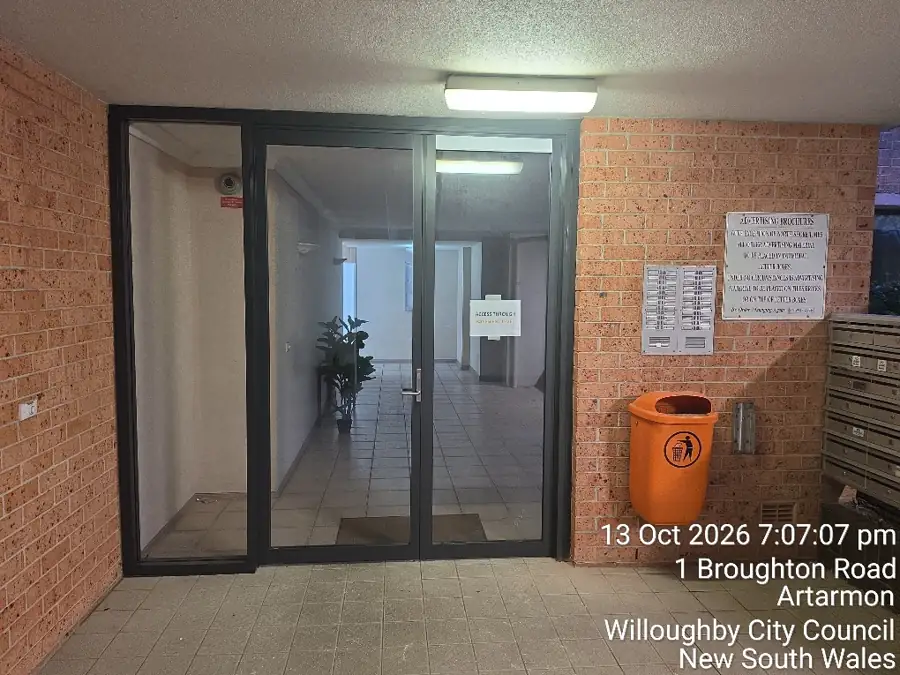

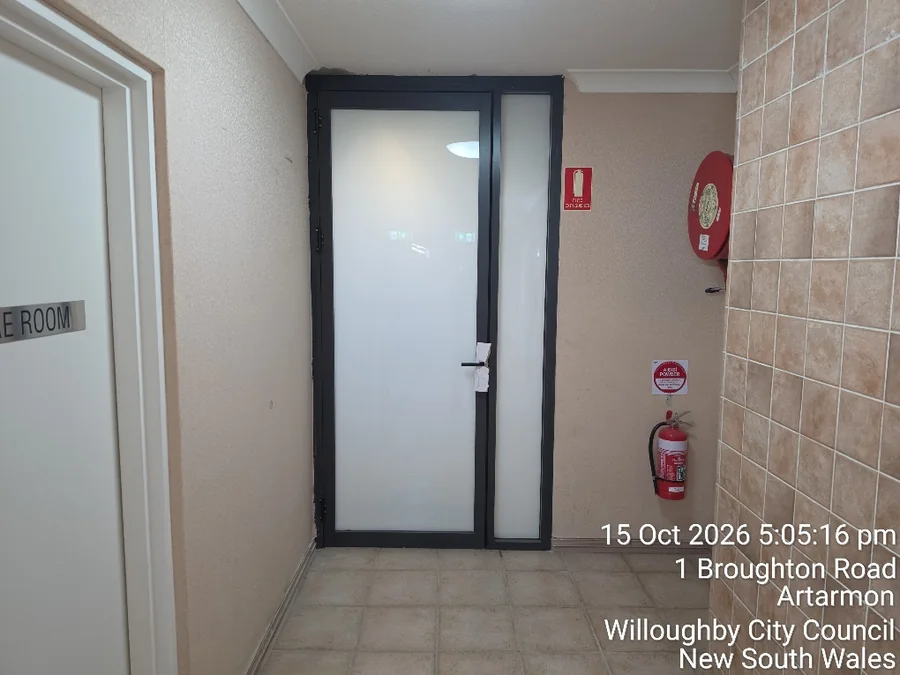

The work includes new windows, entrance doors and electrically operated doors. SCE coordinated the installation sequence, manufacturer follow-up and checks around the openings so that individual components could be resolved before the finishes trades followed.
Resident notices and temporary access arrangements accompanied the entrance works. Door hardware, adjacent finishes and the intercom interface are coordinated with the remaining works and the wider lobby handover.



New letterboxes and a staged changeover

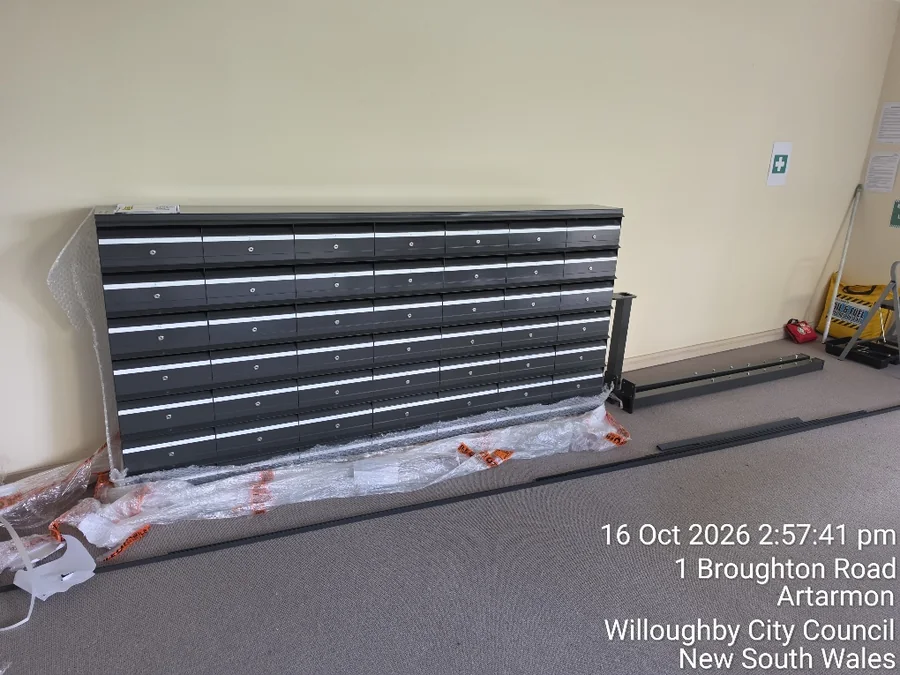

The new letterbox bank has arrived on site and been unpacked. This is a procurement milestone: the unit is available for the next stage, with installation and commissioning still to be completed.
What is checked during a site inspection?
For a letterbox changeover, list installation, resident access, key distribution, identification and any outstanding adjustments. Record who confirms each stage, especially while the building remains occupied.
SCE is coordinating the letterbox works with paving, access restrictions and the other entrance activities. Temporary mail-collection arrangements form part of the sequence while the work area is being upgraded.
The changeover also needs an agreed commissioning date, resident notification and organised distribution of the new keys. These handover arrangements are being coordinated with the client before the new letterboxes enter use.
The wider refurbishment scope
The next stages cover the lobby, external approach and shared facilities, with procurement and trade sequencing underway.
Lobby floors and lift surrounds
The tiling scope includes removal of existing lobby floor tiles, subfloor preparation and new floor tiles, together with replacement wall tiles around the lift. The sequence needs to account for residents, trade access and the interfaces with the new entrances.
Can you provide an example of a scope of works?
A common-area scope could mark lobby floor areas, lift surrounds, retained surfaces and temporary pedestrian routes. Agree protection and access arrangements before ordering finish materials.
External paving and garden-bed changes
External works include garden-bed removal, a reinforced concrete pavement at that location, and surface preparation and tiling to the entrance and walkway. Conduits beneath the new footpath require coordination with the electrician before the pavement is closed up.
Intercom and electrical equipment
Intercom equipment and indoor-monitor options are being reviewed with the client and specialist suppliers. Equipment selection, procurement, electrical interfaces and the installation sequence are being coordinated before testing and handover.
Painting, entry mat and meeting-room details
The client has confirmed paint selections and requested an entry mat that complements the new tiling. Meeting-room cupboard-door details are also being clarified so these smaller components can be coordinated with the main finishes package.
Material choices and programme decisions
When the original tile supply required a longer transfer lead time, SCE checked alternative products and arranged a sample for the committee to review. This gave the client a practical comparison of appearance, availability and the effect on the works programme.
Is project schedule the same as Gantt chart?
A schedule sets the dates and dependencies for deliveries and installation. A Gantt chart displays them. For Artarmon, access notices and tile availability need to align with each lobby stage.
On 16 October, the committee confirmed its preference for the original tile and accepted the associated wait. SCE is coordinating the next steps around that decision. Recording the choice before installation helps keep procurement and the client’s expectations aligned.
Resident communication, signage and access
Construction is taking place in a building people continue to live in. Clear work-area boundaries and timely information are part of the delivery work.
What is the correct order of renovation?
Set out the approved scope, identify the access residents must keep, order long-lead items, stage demolition and installation, then inspect and return each area to use. The Artarmon progress record shows why delivery and handover are separate. The new letterboxes arrived before their changeover with residents.
Work-area separation

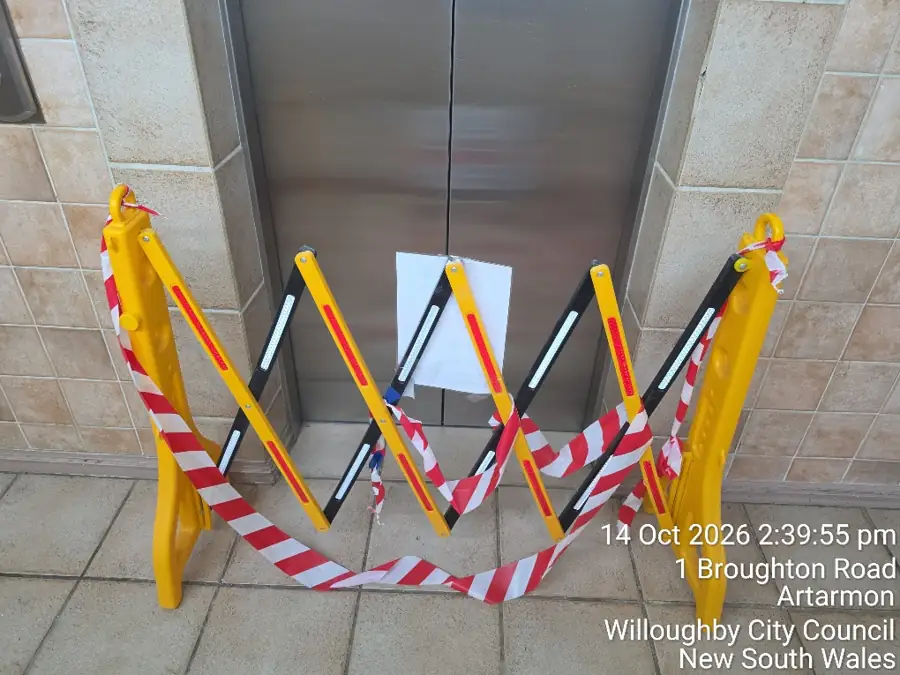

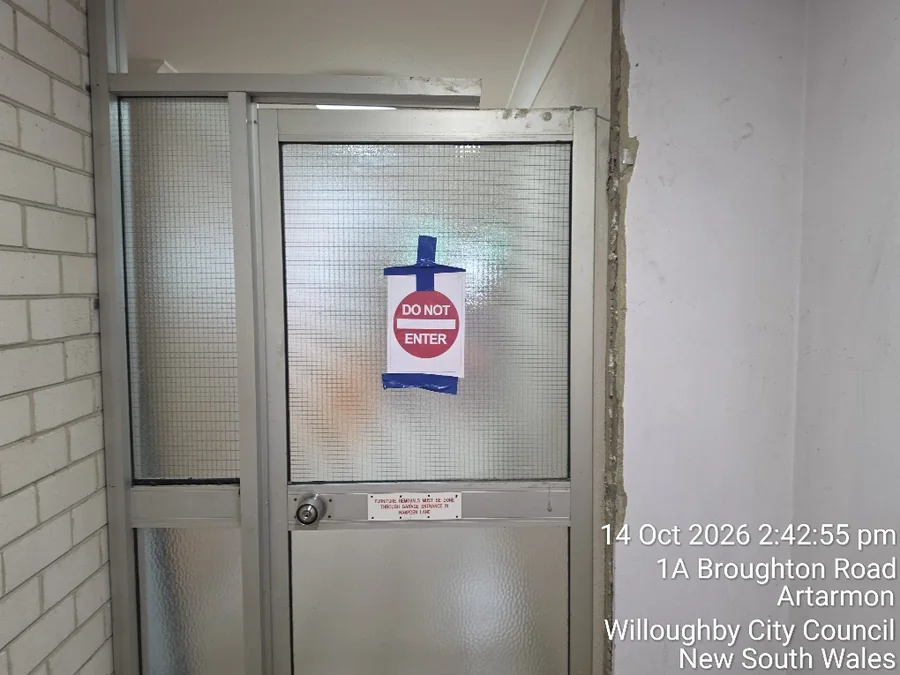

Temporary barriers and entrance signage identify restricted work areas. Additional signs were installed at lobby entrances on 14 October as the access arrangements developed. These controls are coordinated with the work sequence and reinforced through communication with the client and residents.
Notices and day-to-day coordination
SCE works with the strata manager and committee on resident notices, access changes and upcoming activities. Site discussions and follow-up correspondence cover mail collection, material selections, installation timing and the information residents need before a change takes place.


Managing the works and existing-building conditions

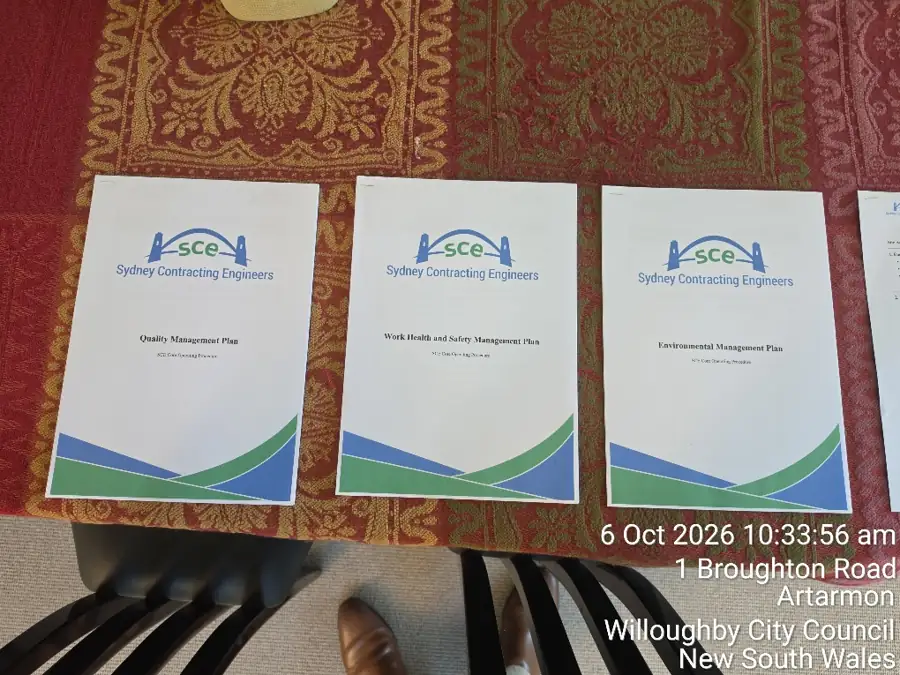

SCE’s building project management role covers trade sequencing, supplier follow-up, client decisions and site documentation. Quality, work health and safety, and environmental management plans have been prepared for the project. See the SCE System and our certifications and credentials for the management framework behind this work.
Response to a concealed water pipe
During the entrance works, an unexpected pipe concealed within the slab was damaged. SCE coordinated isolation of the water supply, repair by a plumber and restoration of the supply on 13 October. The response also included updates to the strata manager and residents.
What is a maintenance request?
A maintenance request should describe the affected location, observed problem, time and any immediate disruption. During the Artarmon works an unexpected pipe in the slab was damaged and the team coordinated isolation and repair. Record urgent notifications and restoration of service separately from routine project updates.
Following the incident, the team confirmed the need for prompt phone updates and visible resident notifications during an unplanned service interruption. Existing-building refurbishment requires both a technical response and clear communication about what happens next.

Remaining stages and handover
The remaining programme brings together the paving and tiling packages, finishes, intercom and electrical coordination, letterbox installation and commissioning. SCE is managing these dependencies with the client and trades as materials and decisions are confirmed.
What is the purpose of a final inspection?
Walk the shared routes, check entrances and fitted items, record outstanding work and assign responsibility. For this continuing project, the final inspection is a future handover milestone.
The project remains active. Completed entrance components are shown here alongside progress photographs and the planned work. Final finishes, testing, outstanding-item checks and the wider project handover are still ahead.
Questions about the Artarmon common-area upgrade
Our strata project planning questions cover briefs, decisions, quotations and communication with owners and residents.
What does the Artarmon apartment common-area upgrade include?
The work covers the building entrances, windows and doors, lobby floor and lift-surround tiling, external paving and entrance finishes, letterboxes, and intercom and electrical coordination. Painting, an entry mat and meeting-room details are also part of the refurbishment. The building contains 48 apartments and remains occupied during the works.
Can residents stay in an apartment building during common-area refurbishment?
Yes, this Artarmon building remains occupied while work proceeds in stages. Access arrangements need to change as each work area opens and closes. SCE coordinates the sequence with the strata manager and committee, uses barriers and signs to mark restricted areas, and provides information about upcoming activities. Continuous access through every work area cannot be assumed.
Which parts of the Artarmon project are complete?
The 16 October 2026 record confirmed completion of the windows, doors, electrically operated doors and initial demolition. The wider refurbishment remains ongoing as at 16 November 2026. The November photographs show walkway preparation and interior works in progress; they do not record completion or final handover of the whole project.
Have the new letterboxes been installed?
The new letterbox bank was delivered and unpacked on 16 October 2026. At that recorded stage, installation and commissioning remained ahead, with the changeover requiring coordination of entrance works, temporary mail collection, resident notification and new keys. The November progress update does not confirm completion of the letterbox installation.
How are residents informed about access changes and work areas?
SCE works with the strata manager and committee on notices, access changes and upcoming activities. Temporary barriers and entrance signs identify restricted areas. Additional lobby signs were installed on 14 October. For an unplanned service interruption, prompt phone updates and visible resident notifications are also part of the communication arrangements.
How are tile choices and material delays managed?
When the original tiles needed a longer transfer lead time, SCE checked alternatives and arranged a sample for the committee to review. On 16 October, the committee chose the original tile and accepted the wait. Procurement and the work sequence are being coordinated around that decision rather than treating an alternative as approved.
How did SCE respond to the concealed water pipe damaged during the works?
SCE coordinated isolation of the water supply, repair by a plumber and restoration of the supply on 13 October. The response included updates to the strata manager and residents. The team then confirmed the need for prompt phone updates and visible notices during an unplanned interruption.
How long does a common-area refurbishment take, and what affects the cost?
The scope, existing condition, access restrictions, material selections, supplier lead times and trade sequence all affect the programme and budget. At Artarmon, the committee’s tile selection and supply lead time affected the sequence. For a new refurbishment, SCE prepares an itemised scope and explains access provisions, material options and dependencies so the committee can compare proposals on the same basis.
What should a strata committee prepare before planning a similar upgrade?
Submit the SCE website enquiry form with the areas to be upgraded, photographs or condition reports, priority repairs, resident access needs and material preferences. Identify who will approve selections and how residents will receive updates. SCE’s occupied-building works planner can help organise these details. Our technical team can explain the proposed scope, alternatives and construction sequence to the owners corporation in plain language.
Planning an upgrade to your apartment common areas?
