Expansion joint repair planning NSW buildings

Expansion Joint Repair Planning for Occupied NSW Buildings: Investigation, Access and Handover

Split sealant, open edges, recurrent leakage, stained finishes and separation at a slab, wall, parapet, balcony or façade junction are conditions to investigate—not instructions to apply another bead of sealant. A reliable plan connects the visible joint to the movement it must accommodate, the substrates it bonds to, the waterproofing and weathering layers it intersects, and the occupied areas around the work.

This guide helps NSW owners corporations, asset managers and property teams prepare an evidence-led expansion-joint repair brief. It supports SCE's building remedial services but does not replace engineering, façade, waterproofing, product, access, approval or safety advice. Broad waterproofing, façade and structural service intent remains with the site's existing specialist pages.

The practical principle

Map the complete joint before selecting the repair. A joint is a moving interface, not merely a line of sealant. Record its geometry, terminations, transitions and connected layers before the visible material is removed.

Separate risk from routine maintenance

First Decide Whether the Area Needs Immediate Control

A failed or displaced joint can coincide with loose finishes, water entry, exposed edges or movement of adjoining construction. The appearance of the sealant alone cannot establish the risk. The responsible duty holders should consider change, location and exposure before arranging routine repair pricing.

Loose or displaced material

Promptly review detached sealant, covers, tiles, render, masonry or metalwork where material could fall or a joint edge has moved out of plane. Do not pull on loose components to test them.

Active water entry

Protect affected people, finishes, electrical services and occupied areas. Record the weather, water path and joint condition before temporary measures obscure useful evidence.

Rapid or unusual movement

Sudden opening, closing, shearing or displacement after impact, nearby works, structural change or severe weather warrants competent site-specific review before the joint is disturbed.

Temporary sealing is not the permanent design. If an interim measure is needed, document its limits, compatibility and removal requirements so it does not conceal change or compromise the final substrate.

Describe before interpreting

Treat Joint Symptoms as Investigation Inputs, Not Diagnoses

Record each condition from a stable reference and inspect the connected construction where safe and accessible. Similar-looking failures can result from different combinations of geometry, movement, adhesion, preparation, moisture, ageing and interface detailing.

Observed conditionQuestions to investigateScope risk if assumed
Sealant pulls away from one edgeWas the adhesion face sound, clean, dry and primed where required? Is the substrate compatible? Is the joint cycling, twisting or moving beyond the installed profile?Another bead may bond to residue or a weak coating and repeat the adhesive failure.
Sealant tears through its bodyWhat was the installed width and depth? Was backing or a bond breaker present? What movement occurred and what capacity was actually designed?A stronger or stiffer material may transfer stress to the edges without correcting the geometry.
Joint is closed, compressed or extrudedIs the opening at one end of its movement cycle? Are covers, backing or debris restricting compression? Have adjoining elements displaced?Cutting out material at the wrong condition can leave insufficient width when the assembly moves again.
Leakage near a joint or terminationWhere is the drainage surface and membrane? How do the joint, upturns, flashings, hobs, thresholds and façade systems connect? Is the visible joint actually the entry point?Surface sealing can redirect water or leave a concealed membrane discontinuity untreated.
Repeated patching or mixed sealantsWhat products and primers were used, where do they start and stop, and are they compatible with each other and the substrates? Why did the prior work fail?Partial removal can retain incompatible material and create irregular movement or adhesion zones.
Cracking beside, rather than in, the jointIs movement being transferred into render, screed, tiles, masonry or cladding? Does the joint align through the assembly? Are restraints or rigid finishes bridging it?Repairing the crack while leaving a bridged or discontinuous movement path may move the failure line.

Do not infer performance from appearance alone. A clean joint can still have inadequate depth, backing, adhesion or hidden continuity. A weathered joint may remain serviceable. The required evidence depends on the building, exposure, consequence and repair objective.

Create a stable information base

Build a Joint Register Before Tendering the Work

A joint register turns disconnected photographs and maintenance notes into an auditable scope. It should use identifiers that remain stable through investigation, design, pricing, construction and handover.

Location and route

  • Building, level, elevation, room, balcony, podium or roof zone
  • Start, end, changes in direction and every intersection
  • Adjoining finishes, cladding, membrane, flashing, drainage and structure
  • Public, resident, tenant, neighbour or plant areas affected

Measured condition

  • Dated width and depth at nominated reference points
  • Edge displacement, opening, compression or shear
  • Sealant, backing, cover, coating and substrate condition
  • Moisture, staining, corrosion, salts, cracking and prior patches

History and exposure

  • Available drawings, specifications and product records
  • Leak reports, weather conditions and seasonal patterns
  • Previous repairs, alterations and adjacent work
  • Monitoring, survey and structural or façade observations

Decision status

  • Verified fact, design assumption or unresolved condition
  • Required opening-up, test, survey or specialist review
  • Temporary control and inspection interval
  • Approved repair detail, hold point and closeout requirement

Photograph the full route as well as close details. Include a scale and joint identifier, but do not place hands, tools or loose objects in an unsafe area simply to obtain a measurement. Use the access system and competent people appropriate to the location.

From symptom to controlled delivery

An Eight-Stage Expansion-Joint Repair Planning Pathway

The sequence can be compressed for a small, low-risk maintenance task or expanded for a regulated, high-access project. Each stage should still create a traceable decision or information set.

Register

Map the joint as one continuous system

Assign stable references and document its complete route, condition, intersections, terminations and affected spaces. Separate an isolated sealant joint from a structural movement joint or proprietary cover system.

Control

Screen safety, weather and occupancy impacts

Have the responsible team decide on exclusion, temporary protection, weatherproofing, support, monitoring or urgent specialist review. Record what an interim measure can and cannot achieve.

Investigate

Confirm geometry, substrates and connected layers

Use targeted opening-up, measurements, product review, survey, moisture investigation or testing to answer defined questions. SCE's visual and intrusive investigation guide explains how to convert unknowns into controlled investigation tasks.

Design

State the movement and weathering basis

The appointed practitioners should define the required movement range, joint configuration, substrate preparation, system components, terminations, transitions, drainage and acceptance criteria for the actual assembly.

Trial

Validate preparation and installation on the real substrate

Where specified, complete a sample or trial that demonstrates removal, edge preparation, backing, primer, sealant or cover installation, finish and testing. Record ambient and substrate conditions.

Stage

Plan access, removal and temporary closure

Sequence complete joint lengths or designed termination points. Coordinate scaffold, elevated work platforms or other access; resident restrictions; plant; traffic; weather windows; daily closure and emergency routes.

Inspect

Hold before concealed work and repetition

Stop at nominated stages for review of prepared edges, measured dimensions, backing or bond breaker, primer, membrane transitions, cover fixings and completed profiles. Resolve departures before repeating them.

Close

Handover by joint identifier

Index products, batches, photographs, measurements, inspections, test results, design changes, as-built details and warranties to the joint register. Define maintenance and future inspection responsibilities.

Coordinate movement, materials and water

Define the Repair Basis Before Naming a Product

Selection should follow the movement and interface requirements, not the other way around. A data sheet is evidence about a product under stated conditions; it is not a project-specific joint design.

Movement and geometry

Confirm the intended joint type, movement range and direction, installed opening across relevant conditions, required width-to-depth profile, backing or bond-breaker arrangement, tolerances and whether a proprietary cover is part of the system.

Substrates and adhesion

Identify concrete, masonry, metal, membrane, coating, render, tile, stone or other adhesion faces. Define removal of old materials, edge repair, dryness, cleaning, primer, compatibility and minimum acceptable substrate condition.

Weathering and drainage

Map the drainage plane, membrane continuity, flashings, cavities, weeps, falls, hobs, thresholds and terminations. The repair should shed or control water without blocking drainage or creating a concealed reservoir.

Fire, acoustic and traffic duties

A joint may also form part of a fire-resisting, acoustic, vehicular, pedestrian or contamination-control assembly. Do not substitute a generic sealant where the joint has another required performance or certification pathway.

Finish and maintainability

Agree colour, texture, edge lines, masking, tooling and acceptable appearance while preserving performance. Provide practical inspection and replacement access rather than burying a maintainable joint behind rigid finishes.

Verification

Nominate trials, substrate checks, adhesion or pull testing, joint measurements, environmental limits, water testing where appropriate, inspection hold points and the records needed to demonstrate the installed system.

NCC interface

Exposed joints on horizontal external surfaces need specific coordination

NCC 2022 Volume One Part F1 addresses exposed construction, control, expansion, contraction and movement joints on roofs, balconies, podiums and similar horizontal surfaces. The project team must establish the applicable NCC edition, state variations, building classification, referenced standards and approval path for the actual work. This guide does not reproduce or replace those requirements.

Where structural movement or distress is genuinely in question, route the matter to the existing structural remedial services pathway and the appointed engineer rather than treating this page as a competing structural-service owner.

Keep the building usable and the repair buildable

Plan Access and Staging Around Occupied Areas

Joint work often follows long elevations, roof edges, balconies, podiums, car parks or internal separations. The access method affects what can be inspected, how removal is controlled, what length can be completed, and how the building remains weatherproof and safe between shifts.

Residents, tenants and neighbours

  • Issue location-specific notices and access windows
  • Coordinate balconies, windows, doors, parking, deliveries and privacy
  • Explain noise, dust, odour, vibration and temporary closures
  • Provide a clear contact and escalation route for active leaks or access issues

Work at height and falling objects

  • Select access for the task and full joint route
  • Coordinate scaffold, platforms, anchors and exclusion areas
  • Protect entrances, paths, vehicles and adjoining property
  • Plan rescue, emergency response, weather limits and daily inspection

Weather and temporary closure

  • Define removal limits for each shift or weather window
  • Protect open joints and connected membranes
  • Set substrate and cure-condition controls
  • Inspect and release temporary closure before reopening affected areas

Quality and production flow

  • Use a signed joint register and daily completed-length record
  • Hold the first repeatable installation for review
  • Separate accepted, provisional and nonconforming lengths
  • Do not let access removal outrun inspections, testing or documentation

SafeWork NSW requires fall risks to be managed at any height, with additional construction-work requirements where a person could fall more than two metres. The project PCBU and duty holders must prepare and implement the site-specific controls required by the actual work.

Keep responsibility explicit

Define Who Investigates, Designs, Installs and Accepts

RoleTypical responsibilityControl question
Owner or owners corporationAuthorise investigation, access, appointments, budget, staging decisions and resident or tenant communication.Who can approve temporary controls, design changes, variations and release of affected areas?
Structural, façade and waterproofing designersAssess matters within their competence and define movement, interfaces, details, regulated documents and acceptance criteria.Who owns the joint across structure, enclosure, membrane, finishes and every termination?
Product or system technical representativeProvide current documented limitations, compatibility, preparation, installation and test information for the specified system.Has advice been reconciled with the project design rather than treated as the design?
Building practitioner and remedial contractorPlan and construct the authorised scope with safe access, temporary weathering, substrate preparation, quality records and notifications.What condition requires work to stop before installation or concealment continues?
Superintendent, certifier or independent reviewerPerform the stated contractual, statutory or assurance function and review nominated evidence.What constitutes acceptance, and who signs each hold point and final register?

For class 2 work, SCE's DBP remedial works guide provides a focused planning pathway. The appointed registered practitioners must determine the regulated design, declaration and Planning Portal obligations for the actual building and scope.

Verified SCE project evidence

A Movement Interface Documented at a Surry Hills Strata Building

SCE completed an approved five-item scope at an occupied Surry Hills strata building: structural assessment and investigations, a building remediation specification, an engineering inspection report, remediation design and tender process management. The project page records SCE's role as contractor and project coordinator with specialist engineering consultant input.

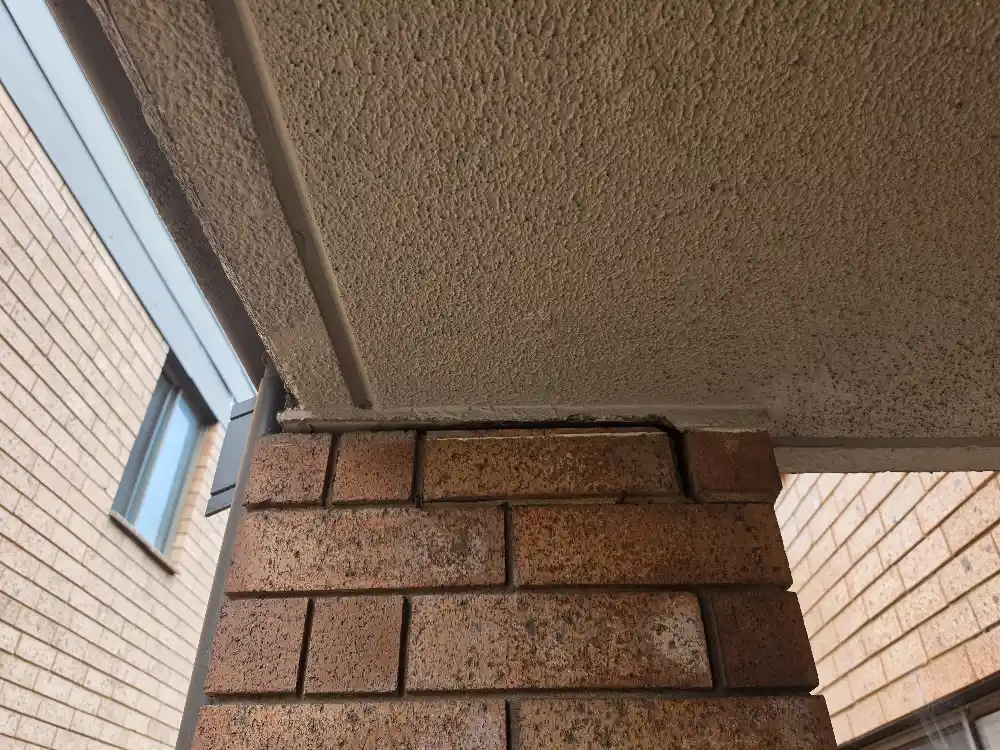

Separation between brickwork and the soffit at an occupied strata building in Surry Hills, NSW
Verified SCE project record: separation documented at the brickwork and soffit junction during the completed Surry Hills strata investigation and remediation-planning scope.

Review the bounded evidence and stated completion outcome on the Surry Hills strata building investigation project page. The photograph documents an interface condition; it does not establish that the interface is an expansion joint, identify the mechanism, or prescribe a repair for another building.

Prepare a comparable enquiry

What to Include in an Expansion-Joint Repair Scope Pack

Register and history

  • Joint identifiers, drawings and full route
  • Dated photographs, dimensions and monitoring
  • Leak history, weather conditions and previous repairs
  • Immediate controls, occupancy and access constraints

Design basis

  • Movement range, geometry and tolerances
  • Substrate, preparation, backing, primer and system
  • Membrane, flashing, façade and termination details
  • Fire, acoustic, traffic or other performance duties

Delivery and closeout

  • Access, protection, staging and temporary closure
  • Trials, environmental controls, tests and hold points
  • Location-specific photographs and approved changes
  • As-builts, warranties, maintenance and inspections

Price the same information basis. Require respondents to identify assumptions, exclusions, provisional quantities, access method, prepared-edge repairs, temporary weathering, design dependencies, test requirements and record deliverables. A metre rate without a defined joint profile and substrate basis is not a complete comparison.

Use SCE's remedial planning tool to organise available information. Where the dominant issue is broader building-envelope performance, coordinate the scope with the existing waterproofing and façade sealing guide rather than assigning the same query intent to both pages.

Frequently asked questions

Expansion Joint Repair Planning FAQs

What should be investigated before an expansion joint is repaired?

Confirm the joint location, construction, substrates, dimensions, condition and intended function before selecting a repair. Record movement or displacement, sealant and backing condition, adhesion faces, contamination, moisture routes, terminations, intersections, adjacent membranes, flashings, finishes and prior repairs. Review drawings and movement assumptions where available, and arrange design, testing or opening-up where the responsible practitioners need it. Keep verified facts separate from provisional conditions.

Can a failed expansion joint simply be resealed?

Sometimes resealing is part of the designed repair, but removing and replacing sealant is not automatically sufficient. Failure may involve unsuitable geometry, loss of adhesion, cohesive tearing, aged backing, incompatible materials, wet or contaminated substrates, excessive or unaccommodated movement, failed terminations, membrane discontinuity or movement elsewhere in the assembly. The scope should correct the relevant mechanism and specify preparation, backing, primer, sealant, profile, movement capacity and inspection requirements.

How are joint width and movement requirements determined?

The responsible designer determines the project-specific movement range and joint configuration using the actual structure, materials, support and restraint conditions, temperature and moisture effects, construction tolerances, existing dimensions and available design information. A product movement rating does not by itself establish a suitable joint. The selected system must be compatible with the substrates and joint geometry and remain buildable across the expected range, including at changes in direction and terminations.

How do waterproofing and façade interfaces affect joint repair?

A joint may cross or terminate at membranes, flashings, cavity systems, cladding, render, parapets, door thresholds, drainage surfaces or other weathering elements. Repairing only the visible sealant can leave a concealed discontinuity or redirect water. The design should map these interfaces, define laps and transitions, coordinate movement and drainage, and nominate opening-up and water-testing requirements where appropriate. Exposed joints on relevant roofs, balconies and podiums also require project-specific consideration of NCC Part F1 and the referenced standards.

Can expansion joint repairs be staged in an occupied building?

Yes, where the responsible team develops a safe, weather-resilient sequence for the actual site. The plan should address access, fall and falling-object controls, resident or tenant communication, noise and odour, façade or balcony restrictions, temporary weatherproofing, daily closure, emergency access, protection of finishes and services, inspection windows and release criteria. Staging boundaries should follow complete joint lengths or designed termination points rather than convenient but technically unsuitable breaks.

What closeout records should expansion joint work include?

Agree the record set before work starts. It may include an indexed joint register, construction-issued details, approvals and declarations, substrate and preparation photographs, joint dimensions, backing and bond-breaker records, product and batch information, primer and compatibility records, environmental conditions, sample or adhesion results, hold-point sign-offs, water-test results where specified, approved changes, as-built locations, warranties, maintenance instructions and residual monitoring or inspection obligations.

Current primary guidance

Useful NSW and National Sources

Primary-source links were checked on 4 September 2026. The applicable NCC edition and state variations, referenced standards, building classification, approval pathway, work health and safety duties and practitioner obligations depend on the actual asset and scope. Confirm current project-specific requirements; referenced standards may require licensed access.

Early scope review

Planning Expansion-Joint Investigation or Repair?

Send SCE the site address, joint register or marked drawings, dated photographs, leak and repair history, dimensions or monitoring, available design information, affected interfaces, access constraints, approval status and required programme. We can review the construction scope and identify delivery questions within SCE's appointed role.

Request a Project Suitability Review

Last reviewed: 4 September 2026. General information only; obtain site-specific safety, structural, façade, waterproofing, fire, acoustic, product, access, planning, DBP and certification advice from the appropriate practitioners and authorities.
