NSW strata and asset planning

Defect Triage for Strata and Asset Owners

A practical framework for separating immediate risk from planned repairs, building a usable evidence record and moving each defect toward the right technical, approval and construction pathway.

Start with consequence, not noise

A defect list is not yet a repair plan

Strata committees, building managers and asset owners often receive a mixture of resident reports, photographs, consultant observations, maintenance requests and quotations. Defect triage turns that mixed information into a controlled decision sequence. Its purpose is to identify what needs immediate controls, what needs prompt investigation, what can enter planned works and what should be monitored with a defined review date.

Triage is not a substitute for engineering, building, fire, waterproofing, electrical or other specialist advice. It helps the asset owner direct the right expertise to the right issue and create a clear path from observation to scope, approval and delivery. For construction-focused support, SCE’s Building Remedial Services team can help translate defined findings into coordinated remedial work while respecting the responsibilities of designers, certifiers, licensed trades and other regulated practitioners.

Priority 1

Immediate risk or active damage

Examples may include an unsafe loose element, uncontrolled water entry near electrical assets, signs of instability, a failed barrier, a blocked essential access route or another condition presenting an immediate safety or property risk. Isolate the area where safe to do so, escalate to the appropriate emergency or specialist response and record the control.

Priority 2

Prompt investigation or containment

The issue is not an immediate emergency, but delay may materially increase damage, disruption or cost. Set an inspection timeframe, define any temporary containment and assign a person to confirm the next decision.

Priority 3

Planned remedial work

The cause and required outcome are sufficiently understood for scoping, access planning, approvals and pricing. Group compatible work where this improves safety, efficiency or reinstatement.

Priority 4

Monitor with a trigger

Monitoring must have a location, baseline, owner, interval and escalation trigger. “Watch it” without those controls is not a closed action and should not disappear into meeting minutes.

Emergency boundary: if there is an immediate threat to people or property, contact emergency services or the relevant authority as appropriate and engage suitably qualified assistance. Do not enter an unsafe area, disturb suspected hazardous material or rely on a webpage to diagnose a structural, electrical, fire or public-safety condition.

A repeatable first response

Six steps for a defensible triage decision

Make the area safe

Apply proportionate temporary controls such as restricting access, protecting occupants, containing water where safe or arranging an emergency trade. Record who authorised the control, when it was installed and when it must be reviewed.

Locate and identify the item

Assign a unique defect number and capture the building, level, room or external elevation, the affected element and whether it is common property, lot property or still uncertain. Confirm ownership from the strata plan and relevant records rather than assuming from appearance alone.

Record observable facts

Use dated photographs showing both close detail and wider context. Note when the issue was first observed, whether it is active or intermittent, recent weather or works, affected services, changes over time and any prior repair history. Separate observations from conclusions.

Set the investigation pathway

Identify the expertise needed to establish cause, extent and repair requirements. One issue may require more than one discipline—for example, water entry may involve drainage, waterproofing, facade, roofing, electrical and internal reinstatement considerations.

Confirm decision and approval gates

Clarify who can approve investigation, temporary measures and permanent work; what committee or owners-corporation resolution is required; and whether authority, access, neighbour, heritage, design or certification constraints apply.

Close the loop

Every item needs a current status, responsible person, next action and due date. After work, record completion evidence, outstanding exclusions, warranties, maintenance requirements and any follow-up monitoring.

Evidence that supports better scopes

Build one defect register that people can use

A useful register lets committee members, consultants, contractors and occupants discuss the same item without rebuilding the story each time. Keep the fields concise, but do not omit decision-critical context.

FieldRecordWhy it matters
Identity and locationUnique number, building, level, room, elevation, grid or marked planPrevents duplicate reporting and supports accurate inspections and pricing.
Observed conditionPlain-language symptoms, date first seen, active or intermittent statusKeeps facts separate from an unverified diagnosis.
EvidenceDated close and context photographs, video where useful, reports and maintenance historyShows extent and progression while preserving an audit trail.
ConsequencePeople, weatherproofing, services, structure, fire safety, access, security, operations and adjacent finishesSupports proportionate prioritisation rather than ranking by complaint volume.
ControlsIsolation, containment, temporary support, signage, shutdown or other interim measureMakes temporary risk management visible and reviewable.
Action ownershipResponsible person, required specialist, approval gate, next action and dateStops defects from remaining open without a decision.
CloseoutApproved scope, contractor, completion evidence, exclusions, warranties and monitoringCreates a reliable asset record after the repair.
Photography tip: capture a wide image that identifies the location, a medium image that shows the affected element and a close image that shows the symptom. Include a scale only when it can be placed safely and without disturbing the defect.

Different symptoms need different pathways

Common triage traps to avoid

Water ingress

Do not treat staining alone as the repair scope. Record whether water is active, likely entry points, drainage conditions, weather patterns, affected services and hidden-damage risk. A cosmetic reinstatement should follow control of the cause and confirmation of suitable drying or removal requirements.

Cracking or movement

A photograph or generic crack-width rule cannot establish structural significance. Record location, orientation, length, change over time, sticking doors or windows, adjacent moisture and any known alterations, then obtain suitable technical advice where the cause or consequence is uncertain.

Facade and overhead items

Loose finishes, balustrade components, awnings and external attachments can create public or occupant risk. Consider access exclusion below the item, wind and weather exposure, height-access requirements and the need for specialist facade or structural review.

Fire and essential services

Do not defer failed alarms, penetrations, doors, hydrants, emergency lighting or other essential-service concerns into a general maintenance list. Escalate them to the appropriately licensed or accredited service provider and preserve service records.

Electrical and wet areas

Water near electrical equipment, damaged cabling or an unexplained loss of supply needs an electrical safety pathway, not a building-only response. Keep people away and use appropriately licensed assistance.

Repeated repairs

Multiple patch repairs at the same location are evidence. Link previous invoices, photographs and weather or usage conditions so the next investigation addresses the recurring cause rather than repeating the same local treatment.

From triage to controlled delivery

Keep professional roles and construction roles clear

Strata and asset decisions are stronger when the required outcome, technical responsibility and construction scope are separated clearly. Depending on the issue, a competent pathway may include a building consultant, structural engineer, waterproofing specialist, fire practitioner, licensed trade, certifier, superintendent or other appropriately qualified person.

SCE can inspect construction conditions within its capability, coordinate access and temporary works, assist with buildability and staging, price a defined scope and deliver building, remedial and civil work where engaged. SCE does not replace the independent designer, certifier, regulator or specialist whose involvement is required for the specific defect.

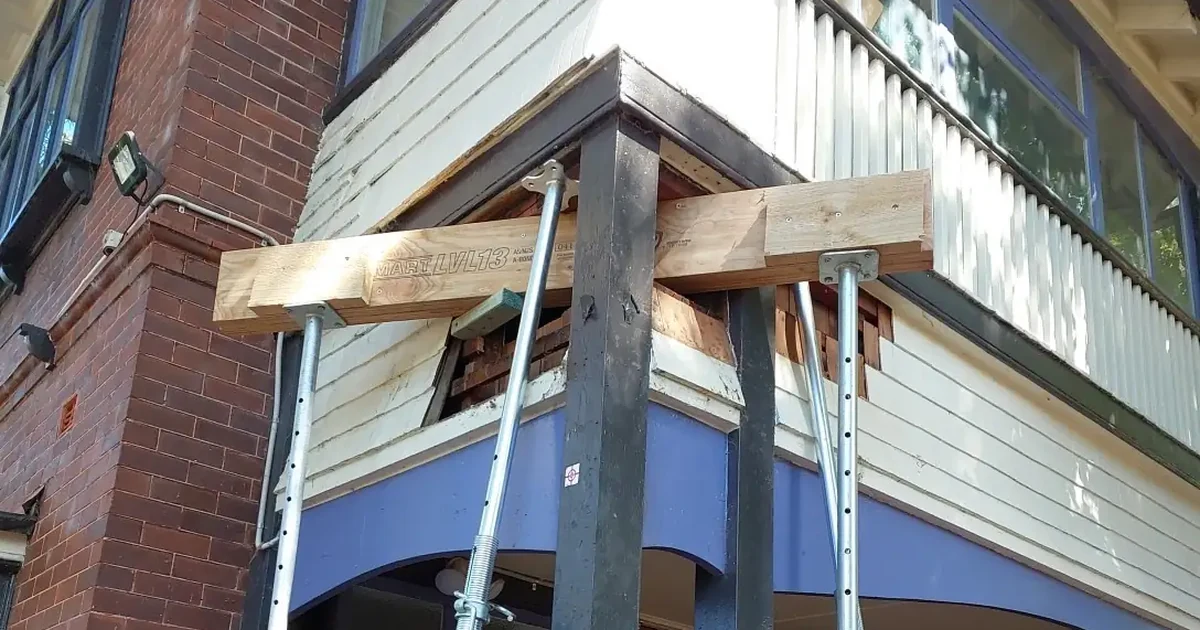

The verified Lane Cove school image shows temporary structural support used during an SCE remedial project. It is an example of a controlled construction measure, not a universal response: temporary works must be designed, installed and reviewed for the actual condition.

Temporary structural support installed during SCE remedial works at a Lane Cove school
Verified SCE project image: temporary structural support during remedial works at a Lane Cove school.

Funding and procurement

Convert priorities into an approved works programme

Once immediate controls and required investigations are assigned, group items by building zone, access method, trade interface, shutdown needs, weather dependency and reinstatement. This can reveal whether several defects share one mobilisation or whether combining them would create unnecessary delay.

Prepare a pricing-ready package

  • Defect register and marked locations
  • Relevant reports, drawings and photographs
  • Defined inclusions, exclusions and performance outcome
  • Access, occupancy, noise, dust and protection constraints
  • Design, approval, inspection and certification responsibilities
  • Provisional items and assumptions that must be resolved

Compare more than the total price

  • Whether every item and interface is covered
  • Temporary works and protection allowances
  • Licensing, insurance and specialist dependencies
  • Programme, shutdown and resident-notification assumptions
  • Testing, handover evidence and warranties
  • Exclusions that could become variations

NSW Government guidance confirms that owners corporations are responsible for maintaining and repairing common property and should use their capital works planning and approval processes to manage repairs. The exact responsibility for an item still depends on the strata plan, by-laws and circumstances. Review the current NSW strata repairs and maintenance guidance and the strata building repairs health check when setting the governance pathway.

Frequently asked questions

Defect triage questions from strata and asset teams

What is defect triage?

Defect triage is a structured way to sort reported building issues by consequence, urgency, information quality and next action. It converts a mixed defect list into immediate controls, investigations, planned works or defined monitoring without pretending to replace specialist diagnosis.

What should happen when a defect presents immediate danger?

Keep people away, use proportionate temporary controls where safe and contact emergency services, the relevant authority or suitably qualified assistance as appropriate. Record the condition and control without entering an unsafe area or disturbing suspected hazardous material.

How should strata teams prioritise water ingress?

Prioritise active water entry, risks to electrical or essential services, occupied areas, progressive damage and potential loss of weatherproofing. Record the wider context and investigate the cause before treating internal staining or finishes as the complete repair scope.

What evidence should be captured for each defect?

Use a unique ID, exact location, dated context and close photographs, observable symptoms, history, affected people or systems, temporary controls, related reports, current owner, next action and due date. Keep observations separate from unverified conclusions.

When is specialist advice needed?

Obtain appropriate professional or licensed advice when the cause, extent, safety consequence, regulated design, approval or certification requirement is uncertain. Structural movement, facade risk, fire systems, electrical hazards and complex water entry commonly require specialist input.

How should defect work be grouped for budgeting?

Group items where they share access, mobilisation, trade interfaces, shutdowns or reinstatement, but do not delay urgent controls merely to create a larger package. Keep scope assumptions and exclusions visible so quotations are comparable.

Can SCE certify the cause or compliance of every defect?

No. SCE can assess construction conditions within its capability, coordinate investigations and deliver defined remedial work, but any required independent design, specialist diagnosis, regulated declaration, approval or certification remains with the appropriately qualified or registered party.

What should a committee confirm before approving a repair scope?

Confirm the responsible property, technical basis, inclusions and exclusions, access and occupant controls, design and approval responsibilities, contractor licensing and insurance, programme, testing, handover evidence, warranties and the process for unexpected conditions.

Current NSW reference points: Strata repairs and maintenance; Strata building repairs health check; Who’s who in strata; and check a builder or tradesperson licence. These sources explain current NSW responsibilities and processes; project-specific legal or technical advice may still be required.

Turn the defect list into a controlled next step

Send SCE the current register, reports, photographs and access constraints. We can review the construction pathway, identify missing scope information and help coordinate practical remedial delivery.

Contact SCE
